Mastering Construction Cash Flow Management: The 2026 Strategic Guide
- Wendy Okie

- 6 days ago
- 12 min read
Why does your bank balance look empty when your profit and loss statement says you're winning? It's a frustrating paradox that many firms face, and it stems from a simple truth: profitability and liquidity are not the same thing. In a market where nonresidential construction costs rose 6.8% over the last year, mastering construction cash flow management is no longer just a back-office task. It's a structural engineering requirement for your firm's survival. You're likely balancing high mobilization costs and delayed retention payments while navigating a 6.75% prime rate, which makes every dollar of tied-up capital more expensive than it was just a few years ago.
We believe your financial data should provide clarity, not confusion. This guide will show you how to move from a state of being "profitable but broke" to one of sustainable, data-driven growth where your bank balance finally reflects your hard work. We'll provide a strategic framework for managing high overhead and navigating the complexities of the 2026 regulatory environment. You'll learn how to build lender-ready financial statements and implement forecasting systems that allow you to fund new projects with confidence and precision.
Key Takeaways
Identify the "leakage points" in your project cycle, from initial mobilization to final retention, where cash often disappears due to administrative gaps.
Distinguish between accrual-basis profit and actual liquidity to move beyond the "profitable but broke" paradox that stalls many growing firms.
Establish a proactive construction cash flow management rhythm using a weekly forecasting model and a specialized Chart of Accounts.
Learn how to use your financial data as a strategic tool for project funding and lender readiness rather than just a record of past transactions.
Discover how strategic oversight from a fractional controller provides the structural framework necessary for sustainable, high-level business growth.

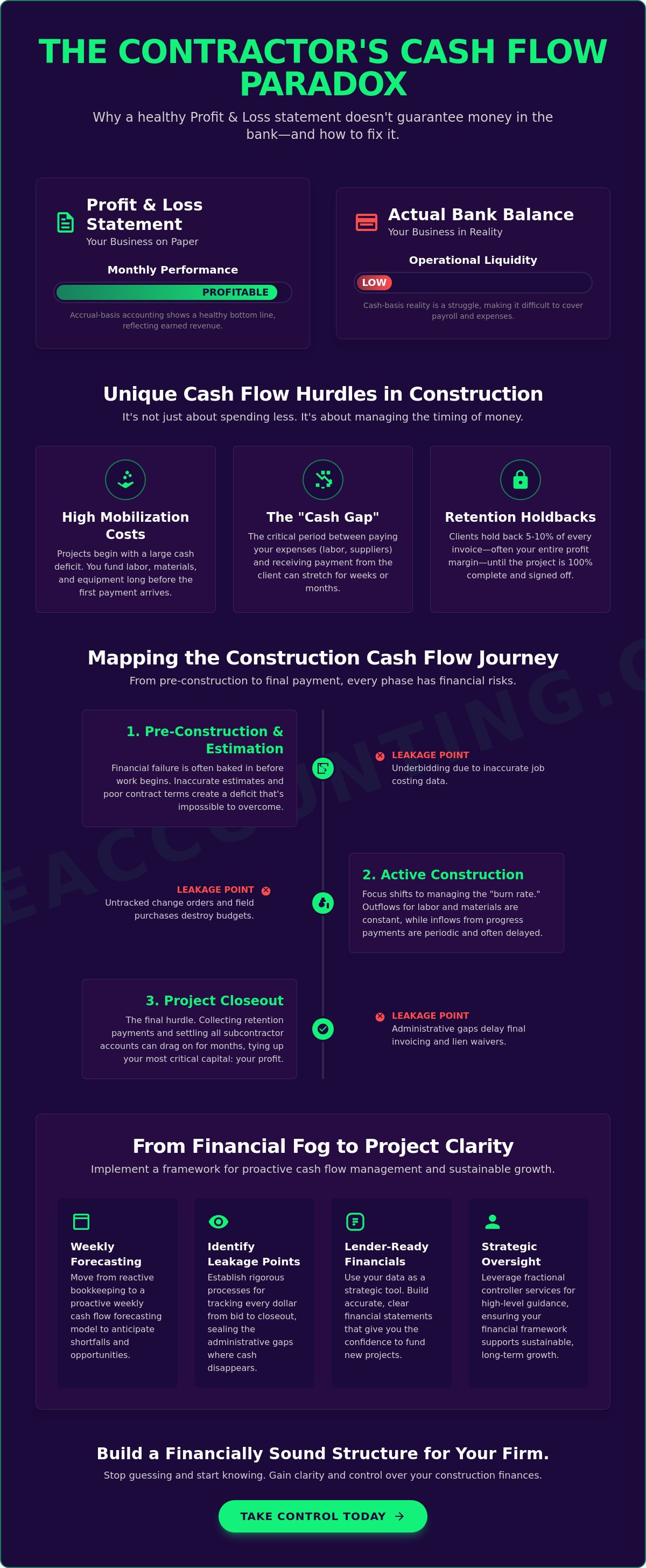

The "Profitable but Broke" Paradox: Why Cash Flow Management is Different in Construction
In the construction industry, profit is often a theoretical concept until the final lien waiver is signed. You might see a healthy bottom line on your monthly report, yet find yourself scrambling to cover Friday's payroll. This "profitable but broke" state is the hallmark of poor construction cash flow management. Unlike retail or service businesses where payment is often immediate, construction is a game of timing. It's the strategic orchestration of inflows versus outflows, where a three-day delay in a progress payment can stall a multimillion-dollar project. You aren't just managing expenses; you're managing the gap between the work performed and the cash received.
Many owners experience a sense of "financial fog" during rapid growth phases. As you take on larger contracts, the complexity of your financial data scales exponentially. This creates a heavy emotional burden; it's the constant anxiety of not knowing if your current bank balance can sustain the next thirty days of operations. Traditional bookkeeping often fails here because it records what has already happened, rather than predicting what will happen next. While an income statement shows historical performance, only robust cash flow forecasting reveals your actual survival capacity and project readiness.
The High Cost of Mobilization and Front-Loading
Every new project begins with a cash deficit. You must fund labor, purchase materials, and pay for equipment rentals long before the first pay application is approved. This front-loading creates immediate negative cash flow. Without a structured framework, firms often fall into the trap of "robbing Peter to pay Paul," using the mobilization funds from a new job to finish a previous one. This practice hides systemic issues until the work slows down and the cash dries up. Negotiating mobilization fees into your contracts is a critical step in protecting your liquidity from day one.
Retention: The Profit That Stays with the Customer
Retention is a unique challenge in this sector. When an owner holds back 5% or 10% of every invoice, they are essentially holding your entire net profit margin hostage until the project is 100% complete. If your accounting system doesn't track these funds separately in your general ledger, your financial health is misrepresented. You may appear to have high accounts receivable, but that money isn't available to pay today's bills. Managing this requires more than basic data entry; it requires strategic fractional controller services to ensure that retention is accurately projected and eventually collected.
Understanding the Construction Cash Flow Cycle: From Pre-Con to Closeout
The cash flow cycle in construction is a long-tail process that begins months before a shovel hits the dirt. It encompasses every financial touchpoint from the initial bid submission to the final release of the lien waiver. Central to this journey is the "Cash Gap," which represents the duration between paying for field labor or materials and actually receiving the owner's payment. Without rigorous construction cash flow management, this gap can expand until it swallows your operational reserves. Success requires a methodical approach to tracking every dollar as it moves through your project pipeline.
"Leakage points" often occur when administrative tracking doesn't keep pace with field activity. If a superintendent approves a field purchase but the receipt doesn't reach the office for two weeks, your real-time visibility is compromised. Accurate job costing is the only way to maintain cycle integrity; it ensures that every dollar spent is allocated to the correct project phase, allowing you to see if a job is "bleeding" before it's too late. By identifying these gaps early, you transform your accounting from a historical record into a proactive project management tool.
The Pre-Construction and Estimation Phase
Financial failure is often baked into a project before it starts. Inaccurate estimates create deficits that no amount of field efficiency can fix. Establishing "Cash-Positive" billing schedules during contract negotiations is vital; this involves front-loading the schedule of values to ensure early inflows cover mobilization and initial overhead. Implementing a professional QuickBooks setup for contractors ensures your initial estimates align perfectly with actual job costs as the project progresses. Utilizing proven strategies to improve cash flow management during the bidding stage sets the foundation for a project that eventually funds itself.
Active Construction: Managing the Burn Rate
Once construction begins, the focus shifts to the "burn rate." You must monitor weekly labor costs against the percentage of completion to ensure you aren't over-spending early in the phase. Change orders are a frequent source of cash flow disruption; if they aren't documented and billed immediately, you're essentially providing an interest-free loan to the owner. Aligning vendor payments with your owner draws is another critical tactic. By negotiating "pay-when-paid" terms with subcontractors, you protect your firm's liquidity from being drained by external payment delays. If you feel your current systems aren't capturing these nuances, you might benefit from a professional financial review to identify where your cash is currently tied up.
Net Profit vs. Cash Flow: Identifying the Hidden Gaps in Your Data
Relying solely on your Income Statement is a dangerous gamble in the construction sector. While a Profit and Loss (P&L) report tells you if you're earning money on paper, it doesn't account for the timing of your bank deposits. You might show a 15% net profit for the quarter while your operating account is dangerously low. This discrepancy exists because accrual-basis accounting recognizes revenue when it's earned, not when the check clears. Effective construction cash flow management requires looking past the P&L to the balance sheet, where the true story of your liquidity resides.
The gap between profit and cash is often found in "Underbillings" and "Overbillings." These figures represent the difference between the work you've performed and the amount you've actually invoiced. If you're underbilled, you've spent money on labor and materials that hasn't been requested from the owner yet, essentially acting as a bank for your client. To bridge this gap, many firms are moving toward monthly financial review services. This structured oversight ensures your reporting reflects actual cash-on-hand rather than just theoretical earnings.
The Overbilling Trap: Why "Extra" Cash is Often a Liability
Overbillings occur when you bill the owner for more than the costs you've incurred to date. While this provides a temporary cash influx, it's a liability, not a windfall. Spending this "extra" cash on overhead or other projects leads to "job bleeding" at the end of the contract when costs remain but billing opportunities are exhausted. You can identify this trap by reviewing these three markers on your monthly reports:
Check for "Billings in Excess of Costs" on your Balance Sheet.
Compare your percentage of completion against your percentage of total contract billed.
Verify that your available cash exceeds your current liabilities plus your total overbillings.
Essential Financial KPIs for Cash Protection
Monitoring specific metrics is vital for maintaining a healthy project pipeline. Days Sales Outstanding (DSO) measures how long it takes to collect payment after an invoice is issued. With the 2026 prime rate at 6.75%, carrying debt to cover slow-paying clients is more expensive than ever. Your Current Ratio, which compares current assets to current liabilities, is another critical marker. Bonding agents look for a ratio of 1.2 or higher to ensure you have the capacity to handle new work. For a deeper dive into these metrics, refer to our guide on financial KPIs for construction to build a more resilient profit protection strategy.

A Strategic Framework for Protecting Your Firm’s Liquidity
Protecting your liquidity requires a shift from reactive data entry to proactive structural management. In a market where the prime interest rate sits at 6.75%, the cost of carrying unbilled expenses or project delays is higher than it has been in decades. To build a resilient business, you must implement a framework that prioritizes visibility and speed. This starts with a Chart of Accounts specifically tailored for construction, ensuring that your financial data is organized by project phase rather than just general expense categories. When your foundational data is clean, you can transition into a weekly rhythm of construction cash flow management that signals trouble before it reaches your bank account.
Standardizing your change order and invoicing processes is the next critical pillar. Delays in documenting field changes are essentially interest-free loans to your owners. By establishing a protocol where change orders are priced, approved, and billed within a 48-hour window, you ensure that cash inflows keep pace with the actual work performed. This discipline, combined with a formal monthly financial review, allows you to adjust your strategy in real time based on actual project performance rather than intuition.
Implementing Cash Flow Forecasting for Construction Projects
There is a vital distinction between company-wide financial health and project-specific liquidity. While your firm may appear stable, a single large project with a massive cash gap can destabilize your entire operation. A 13-week cash flow forecast is the industry gold standard for maintaining visibility into upcoming liquidity requirements. This rolling projection allows you to see exactly when mobilization costs for a new data center project might clash with a delayed retention payment on a completed highway job. For a step-by-step implementation guide, see our detailed resources on cash flow forecasting for construction.
Modernizing Your Financial Infrastructure
Cloud-based tools like QuickBooks Online provide the foundation for a national, remote-ready construction accounting system. The ability to access real-time data from the field ensures that your office team isn't waiting on paper receipts to update the ledger. Integrating your time-tracking and payroll systems directly with your accounting software eliminates manual entry errors and provides immediate visibility into your labor burn rate. Furthermore, utilizing specialized construction payroll services can significantly reduce compliance-related cash leaks, such as miscalculated prevailing wage rates or tax filing errors. If your current systems feel fragmented, you can schedule a discovery call to discuss building a more integrated financial framework for your firm.
Scaling with Confidence: Moving from Basic Bookkeeping to Strategic Oversight
A basic bookkeeper is essential for recording transactions, but they often lack the specialized expertise required to manage the volatile nature of project-based finances. As your firm grows, the complexity of your Work in Progress (WIP) reports and the widening of your "Cash Gap" demand more than just administrative accuracy. You need a structural framework that turns raw data into actionable intelligence. This is the point where construction cash flow management evolves from a survival tactic into a competitive advantage. Relying on a generalist to interpret complex construction cycles often leads back to the financial fog we've worked to eliminate.
Transitioning to a Fractional Controller allows you to drive business decisions based on forward-looking projections rather than historical records. While a bookkeeper tells you where your money went, a controller tells you where it's going and how to protect your margins along the way. This high-level oversight provides the strategic clarity necessary to bid on larger, more lucrative contracts without the fear of a sudden liquidity crisis. You gain the ability to scale your operations while actually reducing your personal stress levels because you finally have a partner who understands the mechanics of your market.
When to Hire a Fractional Controller
Recognizing when you've outgrown your current setup is critical for profit protection. If you find yourself with a growing backlog but decreasing bank balances, or if your bonding agent is asking for more detailed financial readiness reports, it's time for specialized leadership. A controller protects your margins during a scale-up by identifying "job bleeding" early and ensuring your overhead doesn't outpace your gross profit. The ROI of professional oversight is found in the avoided costs of a cash crunch; one missed payroll or stalled project can cost significantly more than the investment in a strategic partner.
Building Your Structural Framework for Growth
The 2026 framework for success is built on foundational systems that mirror the physical structures you build. It requires a clean Chart of Accounts, rigorous 13-week forecasting, and the strategic interpretation of your project data. By moving away from reactive accounting, you establish a business that is lender-ready and capable of sustainable expansion. To learn more about this transition, explore our pillar on how to scale a construction business. If you're ready to move beyond basic administration and secure your firm's long-term health, it's time to Partner with Okie Accounting Group LLC for specialized financial leadership that grows with you.
Securing Your Firm’s Financial Foundation
Mastering construction cash flow management is about more than just surviving the next payroll cycle; it's about building a structural framework for permanent stability. You've seen how the gap between accrual profit and actual liquidity can derail even the most successful projects. By implementing a 13-week forecasting rhythm and moving toward strategic oversight, you replace financial fog with a clear, data-driven roadmap. This transition ensures your bank balance finally reflects the hard work you put into every bid and every job site.
Our team provides specialized expertise in the construction and real estate sectors to help you build a scalable financial infrastructure. We utilize cloud-based systems for national, remote-ready oversight, ensuring your profit protection is never compromised by administrative lag. This shift from basic record-keeping to strategic partnership is what allows you to bid with confidence and grow without the constant weight of financial uncertainty. Ready to transform your financial data into a strategic asset? Gain Strategic Clarity with Okie Accounting Group LLC’s Fractional Controller Services. Your firm's potential is limited only by the strength of its systems. It's time to build a framework that works as hard as you do.
Frequently Asked Questions
What is the most common cause of cash flow problems in construction?
The most common cause is the structural misalignment between project outflows and owner payments, often referred to as the "cash gap." You're required to fund labor and materials weeks or months before you can submit a progress payment application. When high mobilization costs aren't offset by early billings, your liquidity is drained before the project even reaches the midway point.
How does retention affect a contractor’s cash flow?
Retention holds back 5% to 10% of your progress payments until the project is fully completed and accepted. Since this amount often equals your entire net profit margin, you're essentially funding the owner's project with your own profit. This delay in liquidity can persist for months or even years beyond the active construction phase, making it difficult to fund new work.
What is the difference between cash-basis and accrual-basis accounting for contractors?
Cash-basis accounting records revenue only when a check hits your bank account, while accrual-basis records it when the invoice is issued or the work is performed. For contractors, accrual accounting is necessary for accurate Work in Progress (WIP) tracking and financial reporting. However, accrual reports can sometimes mask a liquidity crisis by showing high "paper" profits that haven't actually been collected yet.
How often should a construction company update its cash flow forecast?
You should update your 13-week cash flow forecast every week to maintain maximum visibility. In the 2026 market, where material costs and labor rates fluctuate rapidly, a monthly update is too slow to catch potential deficits. Weekly reviews allow you to adjust your draw requests and vendor payments in real time based on actual field production.
What are "Overbillings" and "Underbillings" in construction accounting?
Overbillings occur when you've billed the owner for more work than you've actually performed, creating a temporary cash influx that is actually a liability. Underbillings happen when you've incurred costs for work that hasn't been billed yet, meaning you're acting as a bank for your client. Balancing these two figures on your balance sheet is a core requirement for effective construction cash flow management.
Can a construction company be profitable but still run out of cash?
Yes, this is a frequent paradox in the industry where high revenue doesn't guarantee liquidity. You might show a healthy profit on your income statement, but if those funds are tied up in underbillings, retention, or slow-paying receivables, you won't have the cash to meet Friday's payroll. Profitability is a measure of long-term health, but cash flow is what keeps your doors open today.
How does job costing improve cash flow management?
Job costing identifies specific "leakage points" where a project is exceeding its budget in real time. By allocating every labor hour and material purchase to a specific phase, you can see if a job is losing money while there's still time to course-correct. This granular visibility prevents a single bad project from draining your firm's total reserves and ensures your construction cash flow management is based on hard data.
Should I use a general bookkeeper or a construction-specialized accountant?
You should always choose a specialized construction accountant who understands industry-specific nuances like WIP, retention, and mobilization. A general bookkeeper often lacks the expertise to manage the complex timing of construction cycles or the requirements of bonding agents. Specialized oversight ensures your financial systems are built for profit protection and long-term stability rather than just basic data entry.
